7 May 2018

Approaching South-bound Completion
CRL's repair teams are steadily completing areas of repair on the southbound deck. The whole of Zone 5 and part of Zone 4 (approx 1km) have been completed and handed over to the deck waterproofing teams. Surface preparation, verge waterproofing and kerb laying is underway.

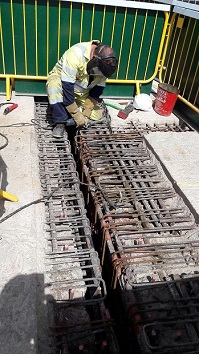

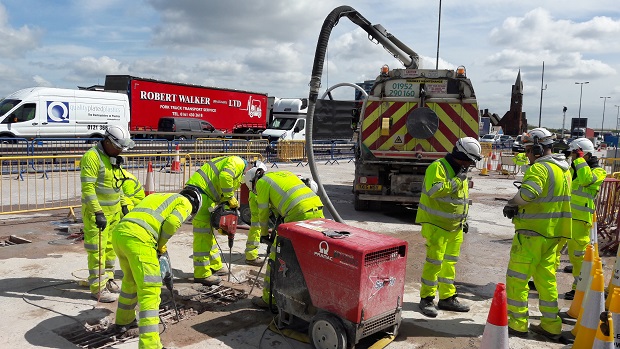

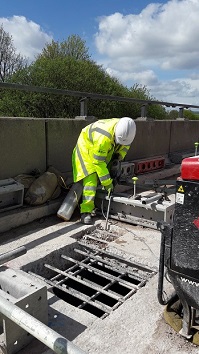

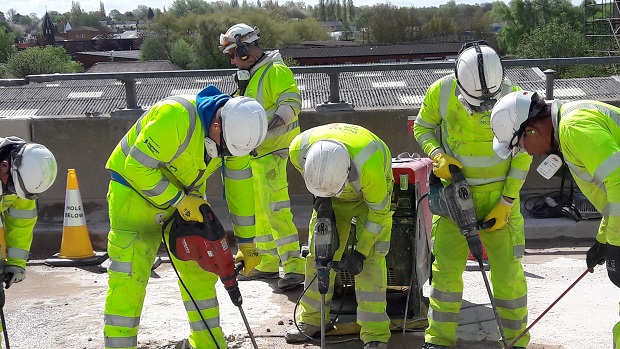

CRL still has two hydro-demolition crews, three welding crews and four trim and repair teams working double shifts, to complete recently released repairs. These are progressing well. Joinery teams are working under the deck preparing areas beneath the northbound carriageway, A CRL team is also underneath doing soffit and edge beam repairs.

The BMV Oldbury team are pushing forward with waterproofing, kerb laying and lighting duct laying and re-surfacing should commence later in May.
